2012

Twitter

Russian Moon missions face three-year delay

Unmanned lunar missions designed to revive Russia's troubled deep-space exploration program will lift off three years later than previously promised. An official announcement of the nation's space science program at a major scientific summit in Moscow revealed significantly delayed launch dates for a trio of lunar probes.

Moon

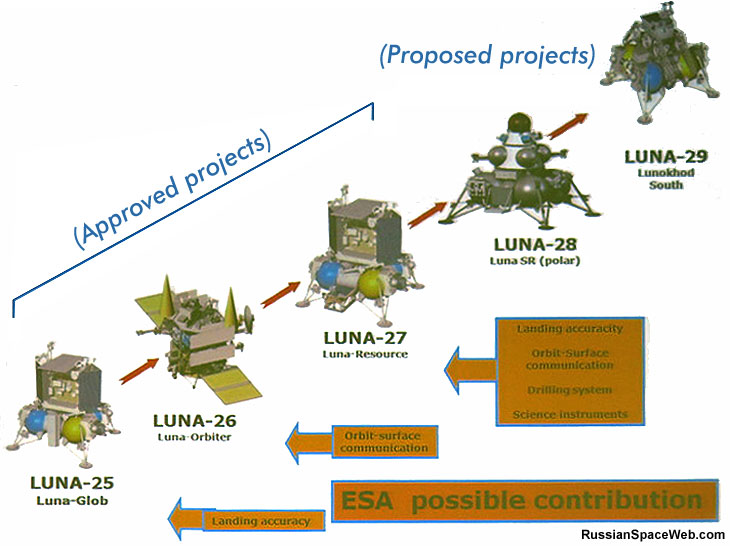

Russian lunar exploration strategy as of 2014 (CLICKABLE).

Mars

Russian Mars exploration strategy as of 2014 (CLICKABLE).

During the 40th assembly of the Committee on Space Research, COSPAR, opened in Moscow on August 2, 2014, Lev Zeleny, the director of the Space Research Institute, IKI, revealed latest schedule for the Russian planetary exploration and space science program. Although all previously approved projects still remain on the table, the nation's series of lunar missions face a domino effect of delays. Russia's first post-Soviet attempt to land on the surface of the Moon was pushed back from 2016 to 2019. Known as Luna-Glob or Luna-25, the unmanned lunar lander was designed to test landing techniques for future lunar missions. On the political front, the successful landing of the Luna-Glob would be a signal to the international scientific community that Russia is back in the planetary exploration business after the 2011 fiasco of the Phobos-Grunt mission. As a result, space agencies around the world would be much more confident that their investments into scientific cooperation with Russia would not be "lost in space."

A three-year delay of the Luna-Glob mission was dictated by a huge pressure on the Russian industry to develop and adequately test a complex landing system for the European ExoMars rover. The Russian space agency, Roskosmos, found itself in the driver seat of the European-led ExoMars program almost overnight, after NASA had bailed out, leaving the flagship project on the brink of cancellation. As a result, the European space agency, ESA, had no choice but to ask Russia to contribute its Proton rocket for the launch and also share the development of the rover's landing platform. Due to a combination of technical and economic problems, none of the Soviet or Russian space probes had ever succeeded in conducting science on the surface of Mars.

Ironically, the ExoMars rover itself will most likely face a delay from 2018 to 2020, even though all official Russian and European schedules still list 2018 as the launch date. However, if ExoMars has to wait until 2020, the Luna-Glob launch in 2019 will still precede the liftoff of ExoMars in 2020.

Two remaining unmanned lunar missions in the approved Russian space program were pushed into 2020s. The lunar-orbiting mission, alternatively known as Luna-Glob-2, or Luna-26, was delayed from 2018 to 2021. In turn, the second lunar lander Luna-Resurs (a.k.a. Luna-27) equipped with a full complement of scientific instruments was now postponed from 2019 to 2023.

If successful, these missions might pave the way to a repeat of the Phobos-Grunt mission now provisionally promised to fly in 2024. More realistically, it could lift off sometime in the second half of 2020s.

In the meantime, previously proposed Russian missions to Jupiter, to Venus, to Mercury and to asteroid Apophis were not included in the 2016 decadal budget, thus pushing their launch dates beyond 2025.

Six lunar missions

In 2014, Roskosmos drafted the new Federal Space Program, which would extend from 2016 to 2025. According to the document, 28 billion rubles would be spent on six lunar missions during this period. (Previous estimates cited 28.5 billion rubles). The first four missions were expected to cost 14.63 billion rubles. Along with two landers and one orbiting mission, which had migrated from the previous 10-year plan, a second lunar orbiter was apparently added to the new program.

The second orbiting mission aims to ensure that at least one such a spacecraft would be available in orbit around the Moon to act as a communications relay station for the Luna-Resurs lander and the Luna-Grunt sample return mission, during their critical approach and descent to the lunar surface now planned for 2023 and 2025 respectively.

A follow-on sample return mission (a.k.a. Luna-Grunt), which was expected to include two spacecraft, would cost another 11 billion rubles. (713)

Russia's planned unmanned planetary missions as of July 2014:

No. Mission
Destination
Launch date
1 ExoMars-2016
Mars orbiter and lander (ESA-led mission)
2016
2 Luna-Glob lander (Luna-25)
Lunar pole lander
2019
3 ExoMars-2018
Mars lander and a rover (ESA-led mission)
2020*
4 Luna-Glob orbiter (Luna-26)
Lunar orbiter
2021
5 Intergelio-Zond-1
Solar probe
2022
6 Intergelio-Zond-2
Solar probe
2023
7 Luna-Resurs lander (Luna-27)
Lunar lander
2023
8 Luna-Resurs orbiter-2 (KVNO-L)
Lunar orbiter
2023
9 Luna-Grunt rover
Lunar sample return mission
2025
10 Luna-Grunt sample return vehicle
Lunar sample return mission
2025
11 Phobos-Grunt-2 (Bumerang)
Phobos sample return mission
2025

*Officially scheduled for 2018

Lunar missions schedule and activities

On May 8, 2014, Section 4 of Roskosmos' Scientific and Technical Council, NTS, reviewed the second amendement to the Preliminary Design, DEP No. 2, of the Luna-Grob development program, OKR.

By the Fall of 2014, Russian officials "advanced" the lunar exploration schedule by two years citing 2017, 2018 and 2019 as launch dates for the Luna-Glob lander (Luna-25),the Luna-Glob orbiter (Luna-26) and Luna-Resurs lander (Luna-27) respectively. The second lunar orbiter was no longer mentioned. The delivery of soil samples from the South Pole of the Moon was promised in a period between 2023 and 2025. As time would show, this schedule turned out to be wildly unrealistic.

On Oct. 9, 2014, Roskosmos issued Decision No. ON-300r on the organization of the flight control system which could support Russian scientific missions, including lunar exploration projects.

Russia's lunar exploration program as of October 2014:

No. Mission
Destination
Launch date
1 Luna-Glob lander (Luna-25)
Lunar pole lander
2017
2 Luna-Glob orbiter (Luna-26)
Lunar orbiter
2018
3 Luna-Resurs lander (Luna-27)
Lunar lander
2019
4 Luna-Grunt rover (Luna-28)
Lunar sample return mission
2025
5 Luna-Grunt sample return vehicle (Luna-29)
Lunar sample return mission
2025

Page author: Anatoly Zak

Last update: May 31, 2023

All rights reserved

insider content

Orbiter

A scale model of the ExoMars-2016 orbiter presented at the Farnborough air show in 2010. Copyright © 2010 Anatoly Zak

Cruise

Artist rendering of the separation between the ExoMars-2018 descent module carrying the rover and the mission's cruise stage in the vicinity of the Red Planet. Credit: NPO Lavochkin

Luna-Glob

Luna-Glob lander as of 2013. Credit: NPO Lavochkin

scale

A scale model of the Luna-Glob orbiter presented at the Paris Air and Space Show in Le Bourget in June 2013. Copyright © 2013 Claude Mourier

Design

Design of Intergelio-Zond as of 2012. Credit: Roskosmos

to Chronology section home to Luna Resurs to Luna-Glob
